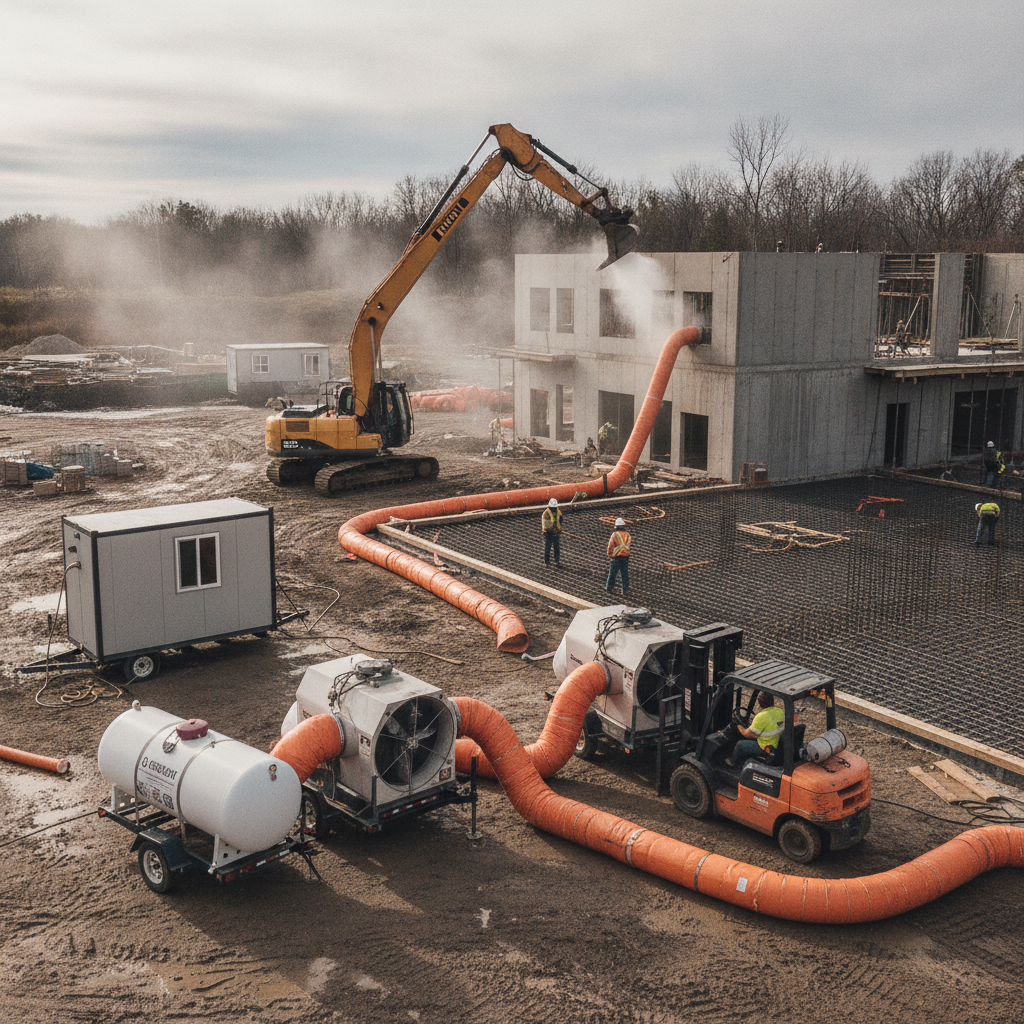

How to Set Up Temporary Heating for Construction Sites the Right Way

How to Set Up Temporary Heating for Construction Sites

Temporary heating for construction keeps concrete curing on schedule, prevents frozen pipes in unfinished buildings, and protects workers when temperatures drop below 40Β°F. Whether you're a general contractor closing in a structure before winter or a farm owner pouring a barn slab in November, this guide walks you through site assessment, heater sizing, fuel planning, placement, and ventilation. By the end, you'll know exactly how to keep a jobsite warm, safe, and code-compliant without wasting fuel or money.

What Is Temporary Heating for Construction and When Do You Need It?

Temporary heating for construction is the use of portable, fuel-fired or electric heat sources to maintain workable temperatures inside partially enclosed or fully enclosed structures during cold-weather building operations. It covers everything from curing concrete to drying drywall mud before final finishes go in.

Who Needs Temporary Construction Heat and What Triggers the Requirement?

General contractors, concrete crews, drywall finishers, painters, and agricultural builders all need temporary heat once ambient temperatures fall below 40Β°F for more than 4 consecutive hours.

Cold-weather concrete pours are the most common trigger β€” ACI 306 standards require concrete to stay above 50Β°F for at least the first 48 hours of cure. Drywall joint compound won't set properly below 55Β°F, and latex paint fails to film below 50Β°F. If you're building a livestock barn, pole building, or equipment shop between October and March in most of the U.S., temporary heat isn't optional.

What Happens If You Skip or Delay Temporary Heating?

Skipping temporary heat during cold-weather concrete work can reduce final slab strength by 40–50%, leading to surface scaling, cracking, and full tear-out within 12 months.

A tear-out and repour on a 2,000-square-foot slab runs $12,000–$18,000. Frozen plumbing lines in a roughed-in structure can burst and cause $5,000–$15,000 in water damage before anyone shows up Monday morning. Delayed drywall finishing pushes your schedule 5–10 days per coat, and that cascading delay costs $800–$1,500 per day in crew standby on a mid-size commercial project.

What Steps Should You Follow to Set Up Temporary Construction Heating?

The setup workflow follows four phases: site assessment, heat-loss calculation, equipment placement, and ventilation and monitoring. Each phase eliminates a specific failure mode before you light anything.

How Do You Assess the Site Before Bringing In Heaters?

Walk the structure and identify every opening larger than 2 square feet β€” doors, window bucks, unsealed penetrations, and incomplete wall sections β€” then measure total enclosed volume in cubic feet.

Multiply length Γ— width Γ— ceiling height. A 40 Γ— 60-foot structure with 12-foot ceilings holds 28,800 cubic feet. Record how many openings remain and their approximate square footage; each unblocked opening bleeds roughly 25,000–40,000 BTU per hour in a 20Β°F wind. Seal what you can with 6-mil poly sheeting and furring strips before sizing your heater.

How Do You Calculate the Right BTU Output for the Space?

Use the formula: Volume (cu ft) Γ— Desired Temperature Rise (Β°F) Γ— 0.133 = BTU per hour required, then add 20–30% for infiltration losses on partially enclosed structures.

For that 28,800-cubic-foot building needing a 40Β°F rise (from 10Β°F outside to 50Β°F inside): 28,800 Γ— 40 Γ— 0.133 = 153,216 BTU/hr base load. Add 25% infiltration and you need roughly 191,500 BTU/hr. Round up to the next available heater size β€” typically a 200,000 BTU unit. Undersizing by even 15% means the space never reaches target temperature, and your concrete cure stalls.

How Do You Place and Duct the Heater for Even Heat Distribution?

Position the heater outside or at the perimeter of the structure, connect supply ducting rated for the unit's discharge temperature, and run it to the center of the heated zone so warm air pushes outward toward the walls.

Keep the duct run under 100 linear feet to limit heat loss in transit; each additional 25 feet beyond that drops delivered air temperature by roughly 5–8Β°F. Elevate the duct outlet 4–6 feet off the slab for concrete curing so warm air blankets the surface without creating hot spots. Use thermometers or data loggers at 3 points across the slab to verify uniform coverage within a 5Β°F band.

What Tools and Equipment Do You Need for Temporary Construction Heating?

A proper temporary heating setup requires three equipment categories: the heat source, ducting and distribution components, and temperature monitoring instruments. Each category handles a different phase of heat delivery; skipping any one category leads to wasted fuel, unsafe conditions, or failed curing.

What Type of Heater Works Best for Enclosed Construction Spaces?

For any enclosed or partially enclosed structure where workers, fresh concrete, paint, or drywall are present, an indirect-fired heater is the standard choice because it vents combustion exhaust outside the heated space.

Direct-fired units dump combustion byproducts β€” carbon monoxide, carbon dioxide, and moisture β€” straight into the workspace. That moisture alone can ruin drywall finishing and add days to dry time. For clean, dry, safe heat delivery, you'll want Indirect-Fired Heaters rated between 150,000 and 400,000 BTU/hr depending on your volume calculation. Look for units with onboard thermostats, fuel-flow shutoff valves, and discharge temperatures in the 170–200Β°F range so ducted air stays effective over runs up to 100 feet.

What Supporting Tools and Accessories Do You Need?

Beyond the heater itself, you need ducting, fuel supply equipment, sealing materials, and monitoring instruments to run the system safely and efficiently.

Plan on these items: 12-inch or 18-inch lay-flat polyethylene duct (enough for your run plus 15% spare); a diesel or kerosene fuel tank with secondary containment if required by local code; 6-mil poly sheeting and a staple gun to seal window and door openings; a CO detector rated for construction environments mounted at breathing height; and at least 3 digital thermometers or wireless data loggers placed at slab level, mid-height, and ceiling level. A 50-gallon fuel tank will run a 200,000 BTU indirect-fired unit for roughly 18–22 hours on diesel.

How Long Does Temporary Construction Heating Take and What Does It Cost?

A typical temporary heating setup takes 2–4 hours to install and runs continuously for 48–168 hours depending on the task, with fuel costs ranging from $150–$600 per 24-hour period based on heater size and outside temperature.

How Many Hours Should You Plan to Run the Heater?

Concrete curing requires a minimum of 48 continuous hours above 50Β°F, while drywall finishing and painting in cold weather may need 72–120 hours of maintained heat per coat cycle.

If outside temperatures stay below 20Β°F, extend concrete heating to 72 hours to reach 65% of design strength β€” the threshold at which freeze damage risk drops significantly. For a full interior finish sequence (two coats of mud plus primer plus paint), plan on 5–7 days of continuous heat. The heater runs 24 hours a day; cycling it off overnight drops slab temperature 15–20Β°F in 4 hours and resets the cure clock.

Is It Cheaper to Own a Heater or Rent One for Each Job?

Rental on a 200,000 BTU indirect-fired heater runs $250–$450 per week plus fuel; purchasing a comparable unit costs $3,500–$7,000, which pays for itself in 8–15 rental-equivalent weeks.

If you run 3 or more cold-weather projects per season and each one needs 1–2 weeks of heat, ownership breaks even by the second winter. Rental makes sense for a single slab pour or a one-time barn project. Factor in delivery fees for rentals β€” they typically add $150–$300 each way β€” versus the convenience of keeping a unit on your trailer year-round.

What Mistakes Should You Avoid When Setting Up Temporary Construction Heating?

Temporary heating mistakes fall into three categories: undersizing the heater, neglecting ventilation and exhaust routing, and failing to monitor temperature at the work surface. The worst outcome is carbon monoxide buildup in an occupied space, which can be fatal within minutes at concentrations above 1,200 ppm.

What Is the Most Dangerous Mistake People Make With Jobsite Heaters?

Using a direct-fired heater in a sealed space without CO monitoring is the single most dangerous error β€” OSHA's permissible exposure limit for CO is 50 ppm over an 8-hour shift, and a 400,000 BTU direct-fired unit in a tight building can exceed that in under 30 minutes.

This mistake happens because direct-fired units are cheaper and easier to set up. Crews seal the building for warmth, then run the heater inside without understanding that every gallon of fuel burned produces roughly 1 pound of water vapor and measurable CO. The fix is simple: use an indirect-fired unit with the exhaust stack vented outside, or if you must use direct-fired, leave at least 4 square feet of ventilation opening per 100,000 BTU.

What Other Common Errors Should You Watch For?

After CO risk, the next most frequent errors are undersizing BTU output, placing the heater too close to combustible materials, and ignoring fuel quality.

Undersizing by 20% means the space sits at 42Β°F instead of 50Β°F β€” enough to stall a concrete cure. Keep the heater and any exposed exhaust components at least 10 feet from stored lumber, tarps, spray foam, and solvent containers. Contaminated or water-laden diesel causes flame-out and sooting; filters clog in 6–8 hours instead of lasting the rated 200-hour interval. Finally, running duct across foot traffic without ramp covers creates a trip hazard β€” OSHA general duty clause violations start at $16,131 per instance.

Frequently Asked Questions About Temporary Heating for Construction

The most common temporary heating for construction questions cover heater type selection, runtime requirements, fuel consumption rates, and safety compliance. The answers below resolve each theme with specific values contractors and building owners can use for planning.

Can You Use a Direct-Fired Heater Instead of an Indirect-Fired Unit?

You can, but only in well-ventilated or open-air spaces where combustion gases disperse freely and no moisture-sensitive finishes are being applied.

Direct-fired heaters deliver nearly 100% fuel efficiency because all combustion heat enters the space. That makes them effective for open-sided pole barns, loading docks, or exterior concrete blanket setups. Inside a sealed structure with workers, drywall, or fresh paint, they introduce too much moisture and CO. The rule of thumb: if you can see the sky from inside the structure, direct-fired can work. If it's enclosed, go indirect.

What Time of Year Should You Plan for Temporary Heating on a Build?

In the northern half of the U.S. (USDA zones 3–6), plan for temporary heating needs from mid-October through mid-April; in the southern half (zones 7–8), December through February is the typical window.

Don't rely on average temperatures alone. A single overnight dip below 32Β°F during a concrete cure can cause surface frost damage even if daytime highs reach 50Β°F. Check 10-day forecasts before scheduling any cold-sensitive work, and have your heater staged on-site 48 hours before the pour so there's no scramble if temperatures drop earlier than predicted.

Should You Handle Temporary Heating Yourself or Hire a Specialty Contractor?

If your project requires less than 400,000 BTU and a single heater with one duct run, a competent crew can handle setup in 2–3 hours with no specialty license required in most states.

Jobs that need multiple heaters, propane manifold systems, or integration with building HVAC rough-ins benefit from a mechanical contractor. Expect to pay $1,200–$2,500 for professional temporary heat installation and monitoring on a 5,000–10,000 square-foot project. For a single barn slab or small commercial build under 3,000 square feet, doing it yourself saves $800–$1,500 and gives you direct control over runtime and monitoring.

How Large a Space Can One Heater Cover?

A single 200,000 BTU indirect-fired heater effectively heats 20,000–30,000 cubic feet with a 40Β°F temperature rise in a reasonably sealed structure.

That covers a 40 Γ— 60-foot building with 10-foot ceilings. For larger structures β€” 60 Γ— 100 feet or 80 Γ— 120 feet β€” you'll need multiple units or a single 400,000 BTU heater with a branched duct layout. Each additional 25,000 cubic feet requires roughly 100,000–130,000 BTU/hr extra capacity. Place units at opposite ends of long structures to prevent cold pockets in the center.

How Often Should You Service a Temporary Heater During a Long Run?

Check fuel level, filter condition, and exhaust integrity every 8–12 hours during continuous operation; replace fuel filters every 200 hours or when inlet vacuum exceeds 8 inches of mercury.

On a 7-day concrete cure, that means at least 2 inspections per day. Look for soot buildup around the combustion chamber β€” visible black residue indicates incomplete burn and reduced output. Top off fuel before overnight runs so the unit doesn't flame out at 3 a.m. and let the slab temperature crash. Keep a spare fuel filter, igniter, and thermocouple on-site so a minor failure doesn't kill 48 hours of curing progress.

Getting temporary heat right isn't complicated β€” it just takes the right-sized equipment and a plan before the cold hits. Forge Claw stocks professional-grade heaters built for exactly this kind of work, sized from small barn pours to large commercial enclosures. Browse the catalog, match the BTU output to your volume calculation, and have it on-site before the first hard freeze catches you off guard.
